BIM for Project Owners: Benefits and Use Cases
Published on

BIM for Project Owners: Benefits and Use Cases

Key Takeaways

  • Design. A coordinated model lets you see the cost and schedule impact of a design change before you approve it. A model change propagates to every drawing automatically, instead of someone updating each sheet by hand, which is where delay and error hide.
  • Construction. BIM prevents budget overruns by catching clashes in the office instead of on site. On one recent industrial project we caught 100 clashes pre-construction, avoiding an estimated SGD 1 million in rework.
  • Operations. The as-built model carries into handover as a single source of truth for the asset, so facility and maintenance teams inherit accurate information instead of a pile of disconnected drawings.

There is growing awareness across the AEC industry of using BIM to drive project productivity: improving design quality, ensuring quality during construction, and creating digital twins that optimize ongoing OPEX during the asset management phase. Most articles frame these benefits for the people who build the model. This one takes the perspective of the project owner.

Building Information Modeling (BIM) is a single, data-rich model of your entire project that every discipline works from, instead of hundreds of disconnected 2D drawings.

In this article, we walk through an owner's key considerations across Design, Construction, and Operations, and give a real-world perspective on the benefits of BIM in project delivery. If you want the definition first, start with what BIM actually is.

What does BIM actually give a project owner?

As an owner, the top priority on any project is making sure the asset you end up with meets the vision you set out to build. Digital delivery serves that priority differently at each phase. In design, the goal is to test multiple design iterations and see the cost impact of each before you commit. In construction, it is to give everyone access to one federated model so buildability problems surface before they are built. In operations, it is to make sure the facility team inherits the most up-to-date information about the asset. The rest of this article follows those three phases in turn.

How do traditional CAD workflows compare to BIM digital delivery?

In practice, we still see a lot of consultancies lagging behind on digital delivery, relying heavily on CAD-based workflows. The problem with CAD is that it is not a data structure. It cannot support rapid iteration of designs, and it holds no intelligent information you can use to assess how a design change affects buildability, cost, schedule, or performance.

You feel this as an owner in the drawings themselves. 2D Computer-Aided Design (CAD) drawings are disconnected pictures: a plan, a section, and an elevation are three separate files that a person keeps in sync by hand. Nothing links them, and nothing links them to cost or schedule. When you ask "what happens to the budget if we move this wall," the honest answer with 2D CAD is "give us a few weeks to redraw and re-estimate."

BIM is a database with a 3D interface. Every element carries data: what it is made of, what it costs, when it gets built. That is why the visibility is different in kind, not just degree.

What you're trying to see

With 2D CAD

With BIM

Does the design actually fit?

Found on site, after concrete is poured
Clash detection in the office, before construction

Cost impact of a change

Manual re-estimate, weeks later
Linked cost data updates as the model changes (5D BIM)

Is the schedule real?

A bar chart nobody can trace to the design
Schedule tied to the model, scenario-tested (4D BIM)

Latest, agreed version

Whichever drawing set each party happens to hold
One shared model in a Common Data Environment

As-built vs. design deviation

Discovered late, disputed
Point cloud scan compared against the model

Design: how does BIM de-risk decisions before I commit?

The design phase is where an owner has the most leverage and the least visibility. Every decision here sets cost and schedule downstream, but with 2D CAD you cannot see the consequence of a decision until someone redraws and re-estimates it weeks later.

BIM closes that gap. A change to the model propagates to every affected drawing automatically. Move a column, and the plans, sections, and elevations update themselves. In 2D CAD, a person updates each of those sheets by hand. That manual step is where delay accumulates and where errors slip in, because sooner or later one sheet gets missed. For an owner, this is why BIM projects absorb design changes faster: the drawings keep up with the decisions.

That propagation is what keeps a project current under pressure. Tender drawings can be regenerated straight from the model to reflect the most up-to-date design, so you are not tendering against a stale set. And when a last-minute design change comes in, it can be handed to the builder as a coordinated model for them to assess buildability, rather than as a marked-up PDF they have to interpret.

A coordinated multi-discipline BIM model, with structural, mechanical, and piping systems combined into a single design view for clash-free coordination
A coordinated multi-discipline BIM model, with structural, mechanical, and piping systems combined into a single design view for clash-free coordination

The payoff is that you can test a decision before you approve it. When cost data is layered onto the model (5D BIM), a design change recalculates its own budget impact, so you are no longer waiting for a manual re-estimate to find out that a "small change" was not small. This is the same coordination gain your consultants get in the design phase, covered in the benefits of BIM for architects and engineers.

Construction: how does BIM prevent budget overruns and delays?

Once the design is coordinated, BIM carries into construction to address the two things that blow up an owner's project: rework and slipped schedules.

The single biggest source of avoidable cost on a project is rework: building something, discovering it conflicts with something else, tearing it out, and building it again. It is expensive not because of the material, but because of the labor, the delay, and the change orders that follow.

BIM addresses this directly through clash detection. When the structural, mechanical, and architectural models are combined into one, conflicts surface automatically: a pipe running through a beam, a duct colliding with a structural member. Found in the office, a clash costs a model edit. Found on site, the same clash costs rework. The return on that is well documented, and I have written about the ROI of strategic BIM services separately, including the numbers.

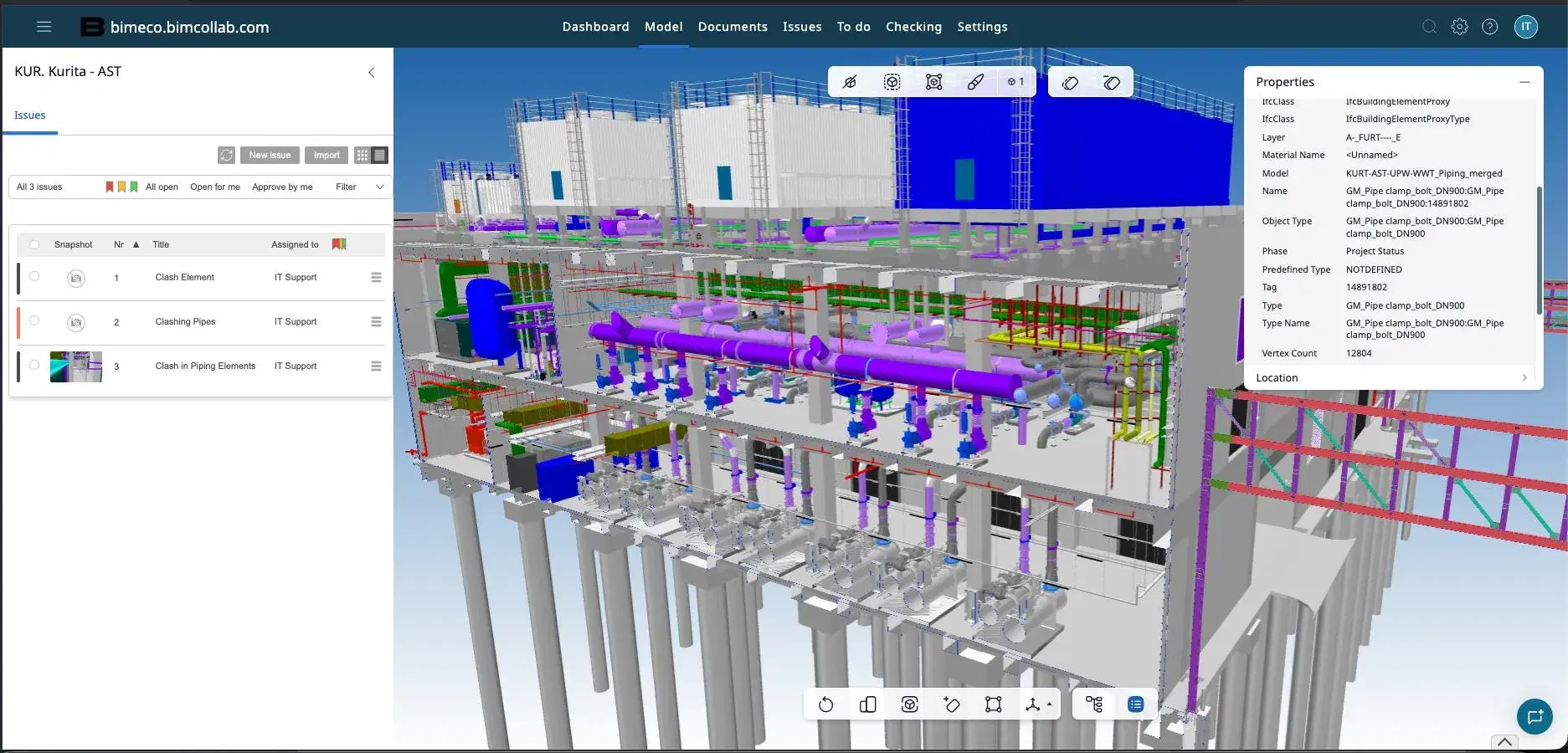

Coordinated BIM model in BIMcollab with a live clash-issues list and element properties, showing conflicts resolved in the office before construction
Coordinated BIM model in BIMcollab with a live clash-issues list and element properties, showing conflicts resolved in the office before construction

On a recent industrial project, we caught 100 clashes in the model before construction, avoiding an estimated SGD 1 million in on-site rework. That is the whole argument in one number: the clashes were found where they cost a model edit, not where they cost torn-out work and change orders. Resolving an issue in the BIM virtual environment avoids the wasted material, the extra logistics, and the schedule delays that are the real cost drivers on a project. This is also why BIM matters to contractors, though for different reasons, which I cover in the benefits of BIM for project delivery.

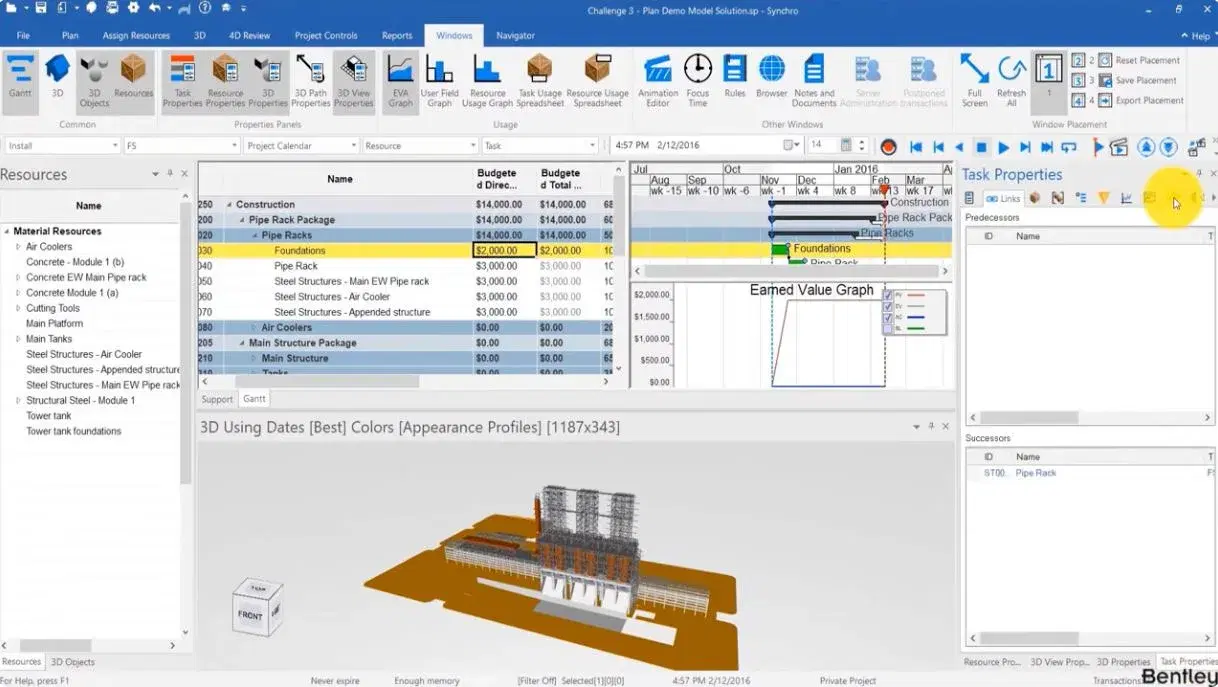

A cost-loaded BIM model, showing budgeted direct and total costs against each construction package with an earned-value graph
A cost-loaded BIM model, showing budgeted direct and total costs against each construction package with an earned-value graph

Schedule is the second front. 4D BIM ties the construction schedule to the model. Instead of a bar chart that nobody can trace back to the design, you can watch the build sequence, spot where trades collide in time and space, and pressure-test the schedule before anyone mobilizes. When leadership suspects the timeline is padded with buffer, this is how you check whether the buffer is real or defensive. More on this in 4D BIM in construction planning.

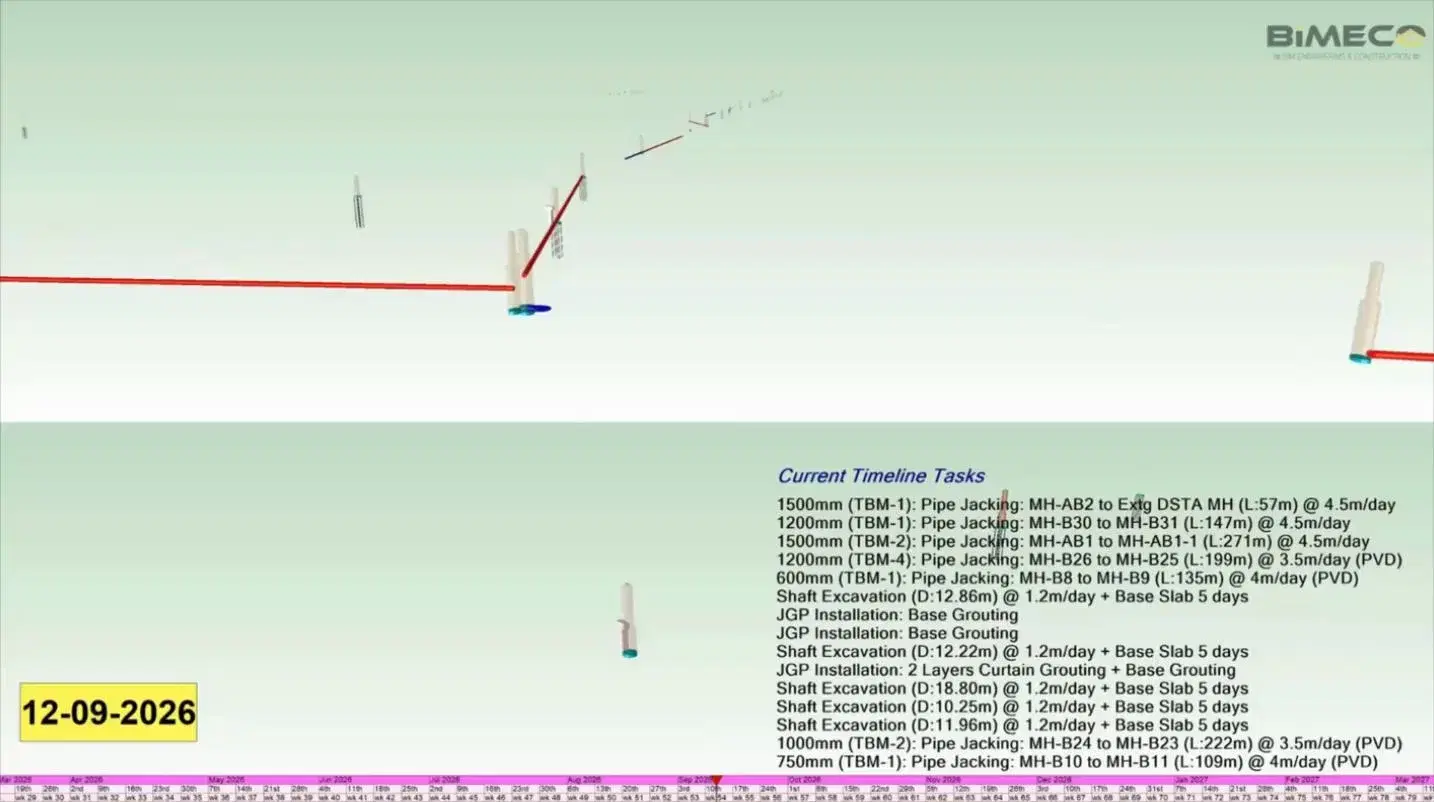

A 4D construction sequence linked to the BIM model, with a dated timeline of tasks showing the build unfolding over the programme
A 4D construction sequence linked to the BIM model, with a dated timeline of tasks showing the build unfolding over the programme

None of this works unless everyone builds from one version of the model. This is the job of a Common Data Environment (CDE): a shared platform that holds the latest coordinated model and controls who can change what, so every decision is made against the current model and stays attached to it. On one waste treatment facility, the piping contractor flagged a rack as too low with a markup straight on the model: "dear racking contractor, the pipe is too low, please shift 10mm up." Where a change needed sign-off, they raised a formal request for information (RFI) against the same model. Every one of those decisions is preserved, so the record that reaches operations later is complete rather than reconstructed after the fact. See our fuller explanation of the BIM Common Data Environment for the mechanics.

A ProjectWise Common Data Environment holding the coordinated project model, with version control and access permissions so every party works from one current source
A ProjectWise Common Data Environment holding the coordinated project model, with version control and access permissions so every party works from one current source

Operations: how does the digital twin cut costs over the asset's life?

Before the model becomes an operational record, it has to match what was actually built. By scanning the completed site and comparing that point cloud against the design model, you can see exactly where the as-built work deviates from what was designed, instead of arguing about it after handover. That comparison is the subject of comparing design models with point cloud and LiDAR (Light Detection and Ranging). For an owner, this is quality assurance you can see for yourself rather than take on faith.

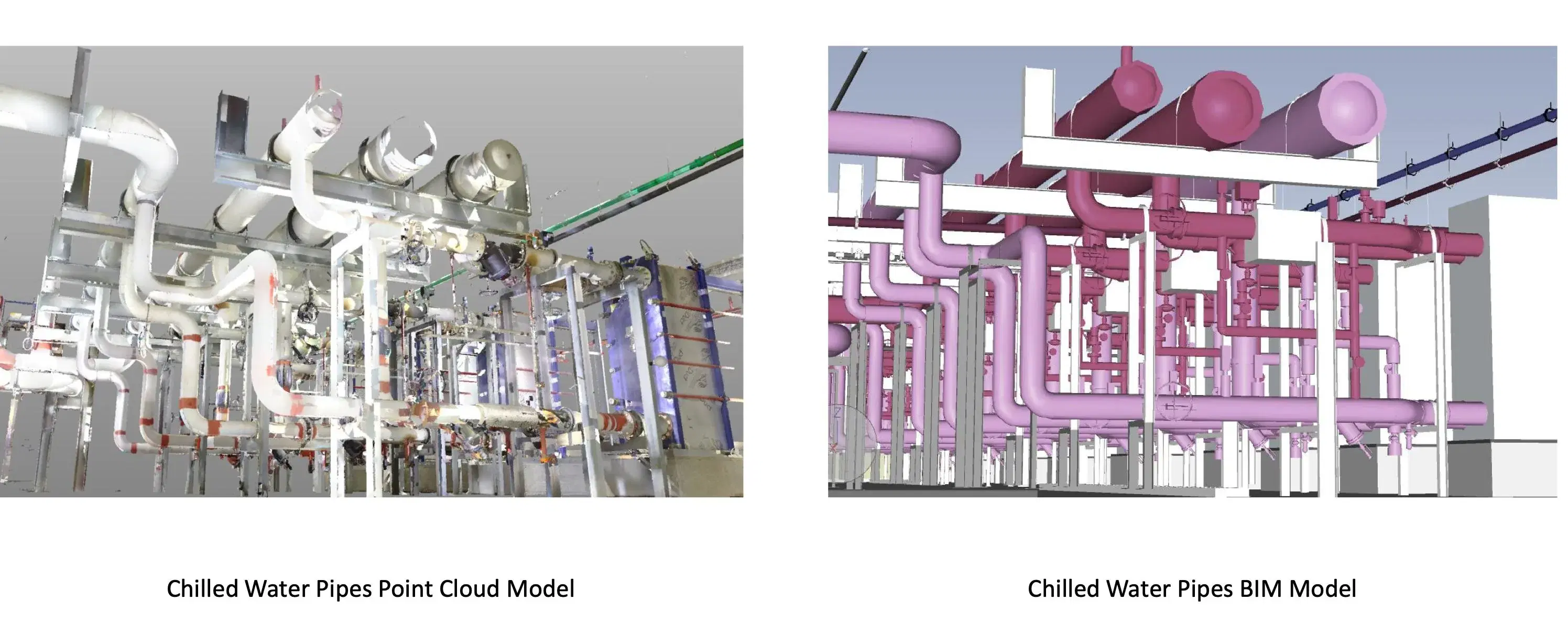

A laser-scanned point cloud of chilled water pipes on the left, next to the coordinated BIM model built from it on the right
A laser-scanned point cloud of chilled water pipes on the left, next to the coordinated BIM model built from it on the right

The model does not stop being useful when construction ends. At handover, the verified as-built model is enriched with asset information (make, model, warranty, service dates, O&M documents) to become a 6D BIM model, the operational record for the building. This is where BIM pays back over the longest horizon, because the information captured during design and construction becomes the record that maintenance, space planning, and asset management run on for the life of the building, instead of being lost in a handover box of disconnected drawings.

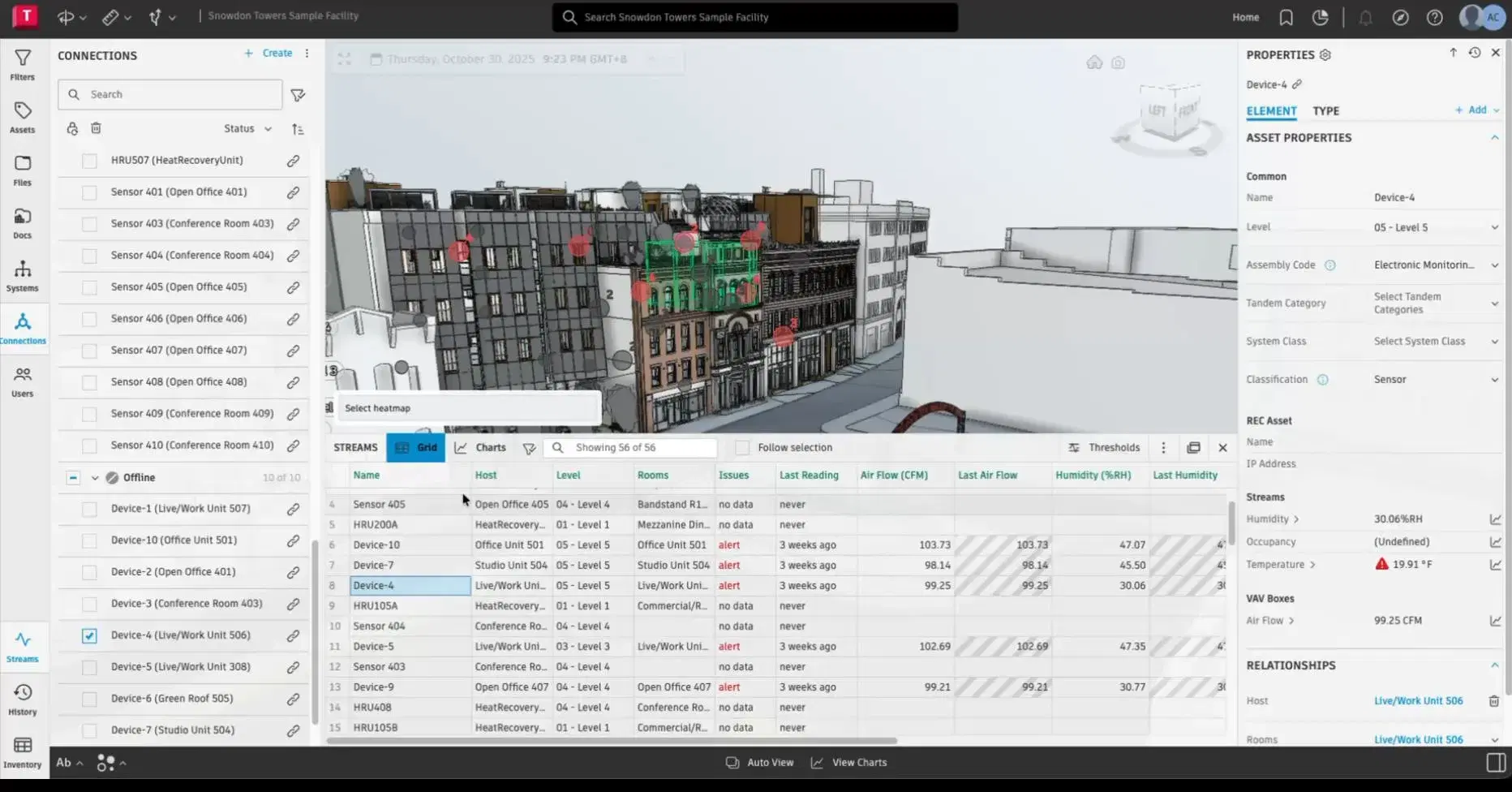

An Autodesk Tandem digital twin of a building, pairing the as-built 3D model with asset, systems, and space data for facility management
An Autodesk Tandem digital twin of a building, pairing the as-built 3D model with asset, systems, and space data for facility management

That 6D model becomes a live monitoring twin when it is integrated with the building's sensors: the digital twin pairs the 3D model with real-time data on air flow, temperature, and equipment status, so the facility team runs modern FM workflows from one source of truth. Instead of chasing paper records to find when a vessel was last serviced or who manufactured it, an operator clicks the asset in the model and the information is there.

The bottom line for owners

BIM delivers benefits across the whole lifecycle: coordinated design, cost and schedule control in construction, and a digital twin that runs facility management.

You do not have to build that capability in-house to get it. A digital delivery partner like Bimeco links up with your consultant, builder, or subcontractors and acts as the modeling arm for the project. Its real job is to bridge the gap between your project goals and the varying digital maturities of the stakeholders delivering it: architects, consultants, and builders are rarely at the same level, and the partner keeps everyone working to one standard regardless. This makes it the best option when your delivery teams are lower in digital maturity, and it is equally useful for engineering teams that are shorthanded, or for owners who want a trusted partner to oversee digital delivery across the entire project lifecycle.

If you want to talk through how to bring BIM into your project, drop us a line.

Glossary

  • BIM (Building Information Modeling): A single, data-rich model of a project that all disciplines work from, replacing disconnected 2D drawings.
  • CDE (Common Data Environment): The shared platform that holds the current coordinated model and controls access, so everyone works from one source of truth.
  • Clash detection: Automatically finding physical conflicts between disciplines (e.g. a pipe through a beam) in the model, before construction.
  • 4D BIM: The model linked to the construction schedule, so the build sequence can be simulated and pressure-tested.
  • 5D BIM: The model linked to cost data, so a design change shows its budget impact immediately.
  • Point cloud: A dense set of measured points from a laser scan of the real site, used to check the as-built against the design.

Frequently Asked Questions

For a project owner, the main benefit of Building Information Modeling (BIM) is visibility and control. BIM gives you a single, queryable model of the whole project instead of hundreds of disconnected 2D drawings. You can see where a design change hits the budget, whether the schedule is real or padded with buffer, and where the risks sit, before money is committed on site. It shifts you from trusting a status report to being able to interrogate the actual project data.
Building Information Modeling (BIM) is the coordinated 3D model created during design and construction. A digital twin is what that model becomes in operation: the as-built BIM model, enriched with asset data and connected to live sensor readings, so it stays in sync with the real building as it is used. Put simply, BIM helps you design and build the asset; the digital twin helps you operate and maintain it. For an owner, the key is to treat the BIM deliverable as the seed for the twin, aligning asset tags and equipment IDs early so the handover model is ready for facility management.
Not every project needs a sensor-rich digital twin. For simpler buildings, a well-structured as-built Building Information Modeling (BIM) model may be enough for maintenance and future renovations. A full digital twin delivers the most value on complex, mission-critical facilities such as hospitals, data centres, and manufacturing or process plants, where uptime, energy use, and lifecycle planning drive real operating cost. Match the investment to how complex the asset is to operate.
Yes. You do not have to start Building Information Modeling (BIM) at day one. If your design is in 2D Computer-Aided Design (CAD) and no contractor has been engaged, a digital delivery partner can convert the existing drawings into a coordinated BIM model. This gives you clash detection, scenario modeling, and a single source of truth from that point forward, without restarting the design. Adding BIM mid-project is common on jobs that have already drifted over budget and need visibility restored fast.
Building Information Modeling (BIM) prevents budget overruns mainly by catching design conflicts before construction. When the structural, mechanical, and architectural models are combined, a clash (a pipe running through a beam, a duct through a wall) shows up in the office, where fixing it costs a model edit. The same clash found on site costs rework: torn-out work, idle labor, and change orders. Layering cost data onto the model (5D BIM) also lets you see the budget impact of a design change immediately, rather than weeks later.
You do not need in-house Building Information Modeling (BIM) capability to start. The usual route is to engage a digital delivery partner who acts as the modeling arm for the project, taking your team's 2D Computer-Aided Design (CAD) plans and turning them into coordinated BIM models. This works well when your consultants and builders sit at different levels of digital maturity, because the partner keeps everyone working to one standard. It lets you get clash detection, coordinated drawings, and a handover model without waiting for every party to build its own BIM team.
The cost of developing a coordinated Building Information Modeling (BIM) model is a scopeable line item, driven mainly by the size of the facility and the level of detail required. The budget covers the coordinated model and the drawings extracted from it, not a software licence. The BIM partner holds the authoring tools and hands over the model; if you want to edit it yourself, you can license the software separately.
